New Pump Station at Mill Creek Plant





Rendering of Mill Creek pump station

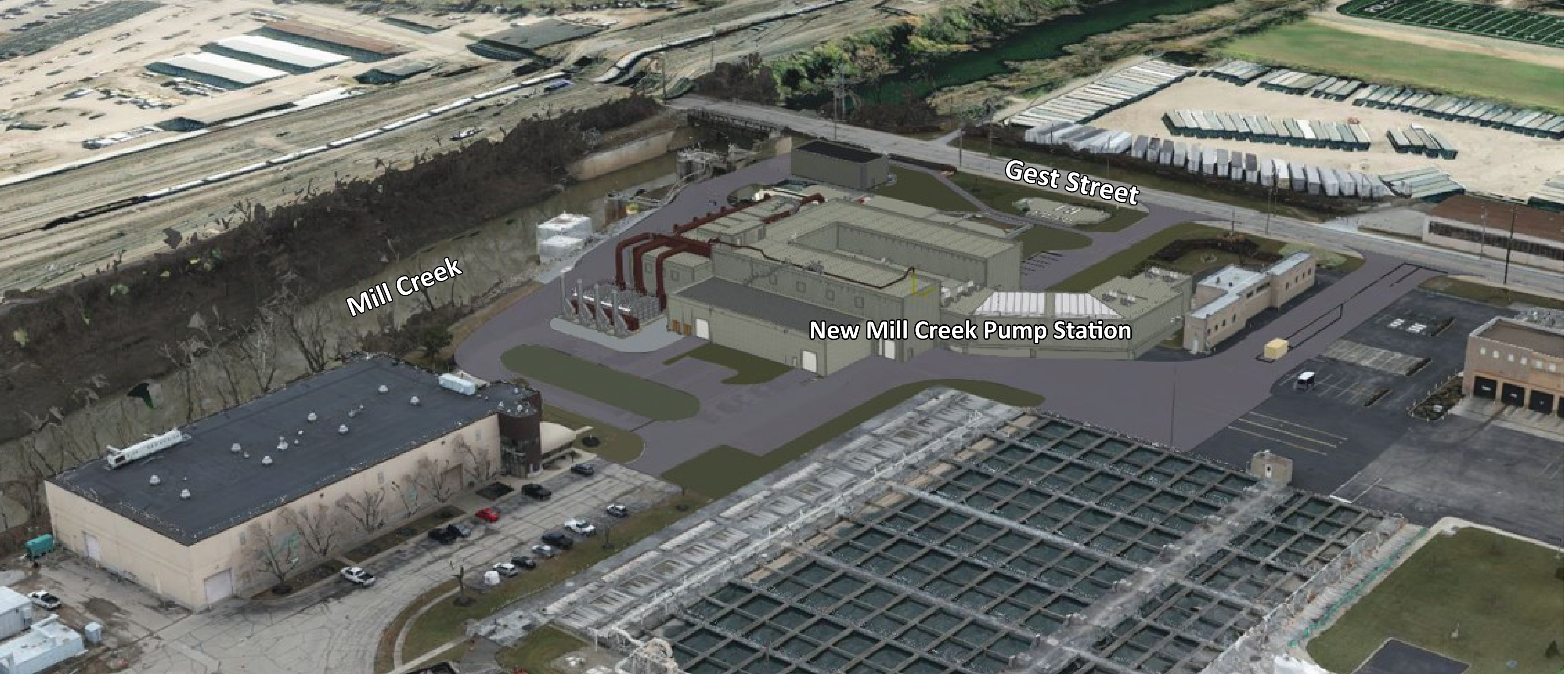

Artist rendering of the new 700 MGD pump station and associated facilities at the Mill Creek treatment plant (looking southeast toward Gest Street) - subject to change.





OVERVIEW

MSD is designing and constructing a new 700 million gallon per day (MGD) influent pump station at the Mill Creek Wastewater Treatment Plant in Lower Price Hill/Queensgate.

  • The new pump station will replace an existing 430 MGD pump station and nearly double pumping capacity.
  • The new pump station will direct wastewater flows to either the Mill Creek plant or to a future high-rate treatment facility at the Mill Creek plant that would only operate during rain events to treat excess wastewater flows.
  • The project also includes a new bar screening facility, odor control, and a new disinfection facility, among other improvements.

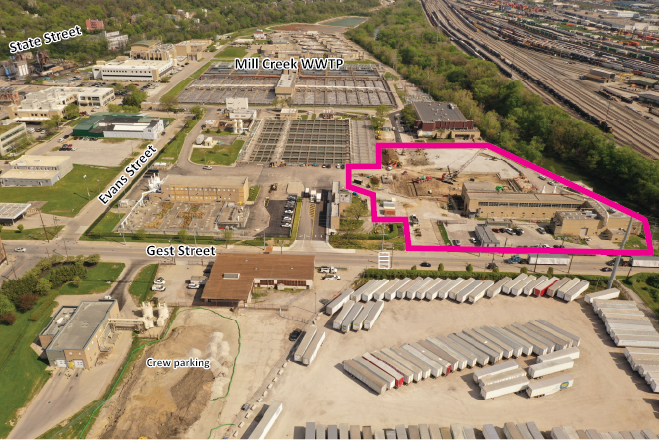

  • To make room for the new facilities, the old Administration Building and the Administration Building Annex on the southeast side of the plant will be demolished.
  • In addition, MSD will need to relocate the main plant entrance (off Gest Street), recongifure the plant entrance off Evans Street, and relocate the document storage room. A third floor, with geothermal heating/cooling, will be added to the Central Maintenance Facility (CMF) building at the Mill Creek plant to accommodate document storage.



PROJECT STATUS

  • Construction began in January 2025 and is expected to be completed in 2032. See the construction schedule below.
  • Ulliman Schutte Construction was awarded the progressive design-build contract in June 2023.



rendering of Mill Creek pump station
Artist rendering of the new 700 MGD pump station and associated facilities at the Mill Creek treatment plant (looking southwest toward Gest Street) - subject to change.





CONSTRUCTION SCHEDULE (SUBJECT TO CHANGE)

This project is being conducted in sequences:

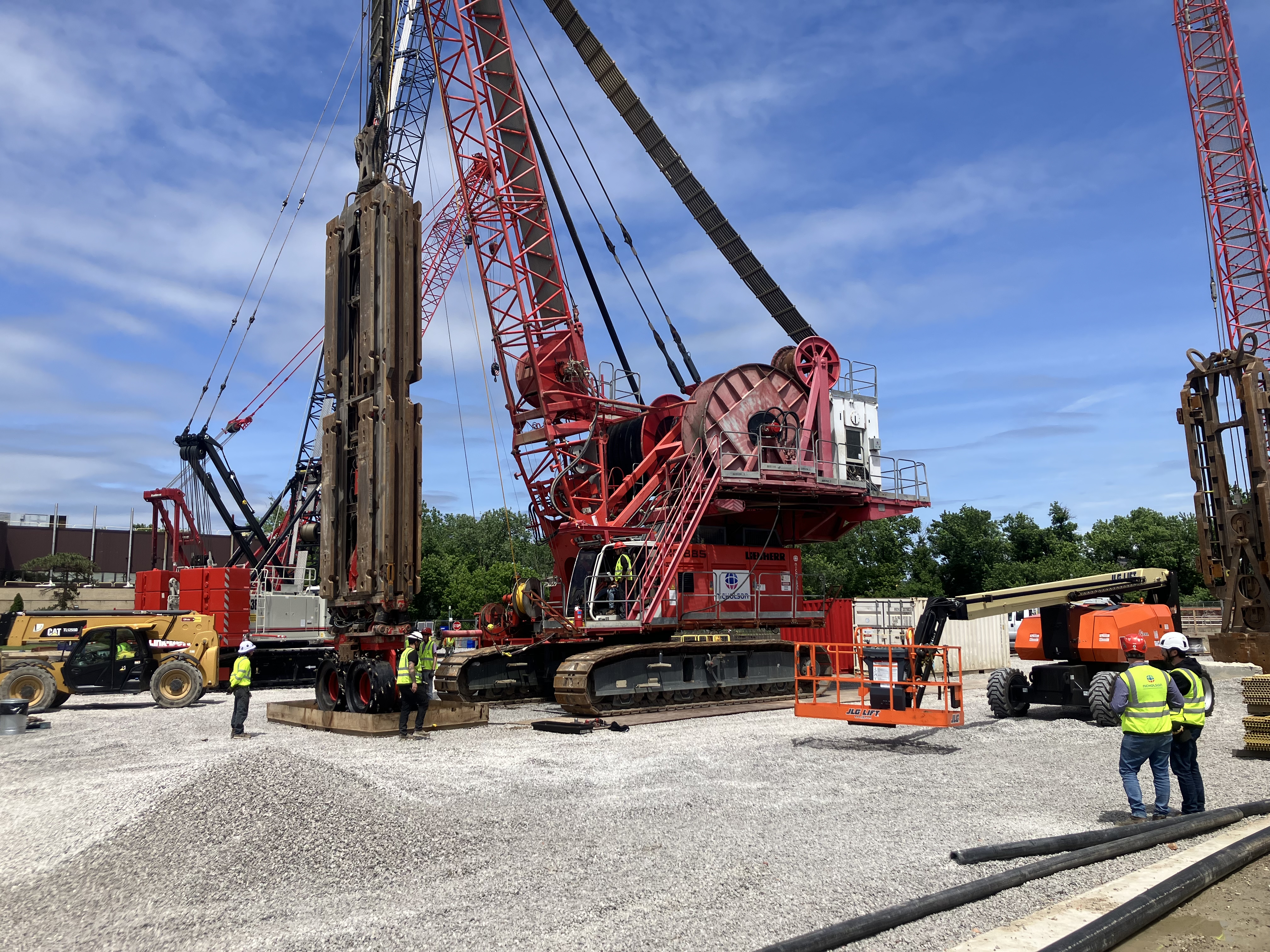

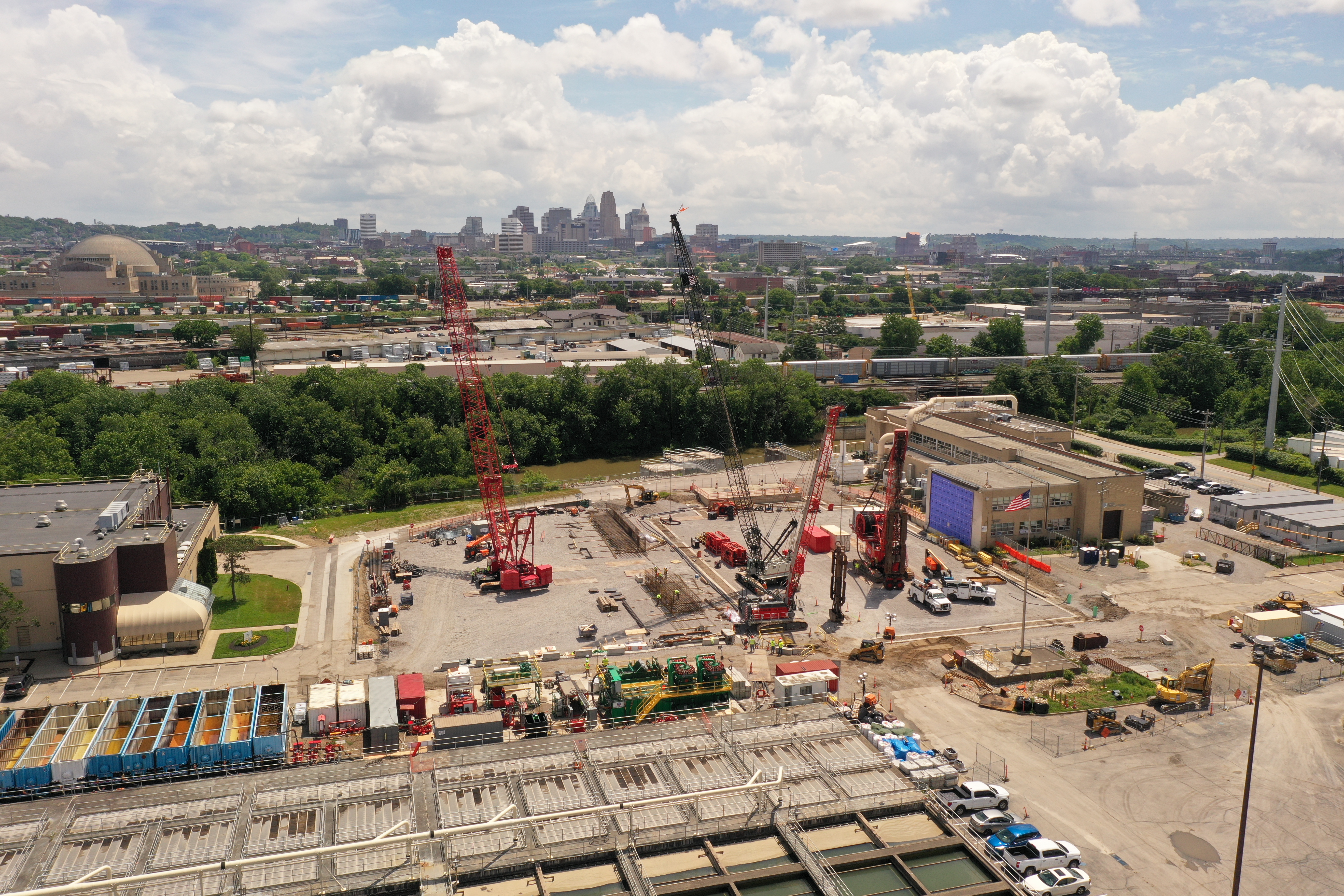

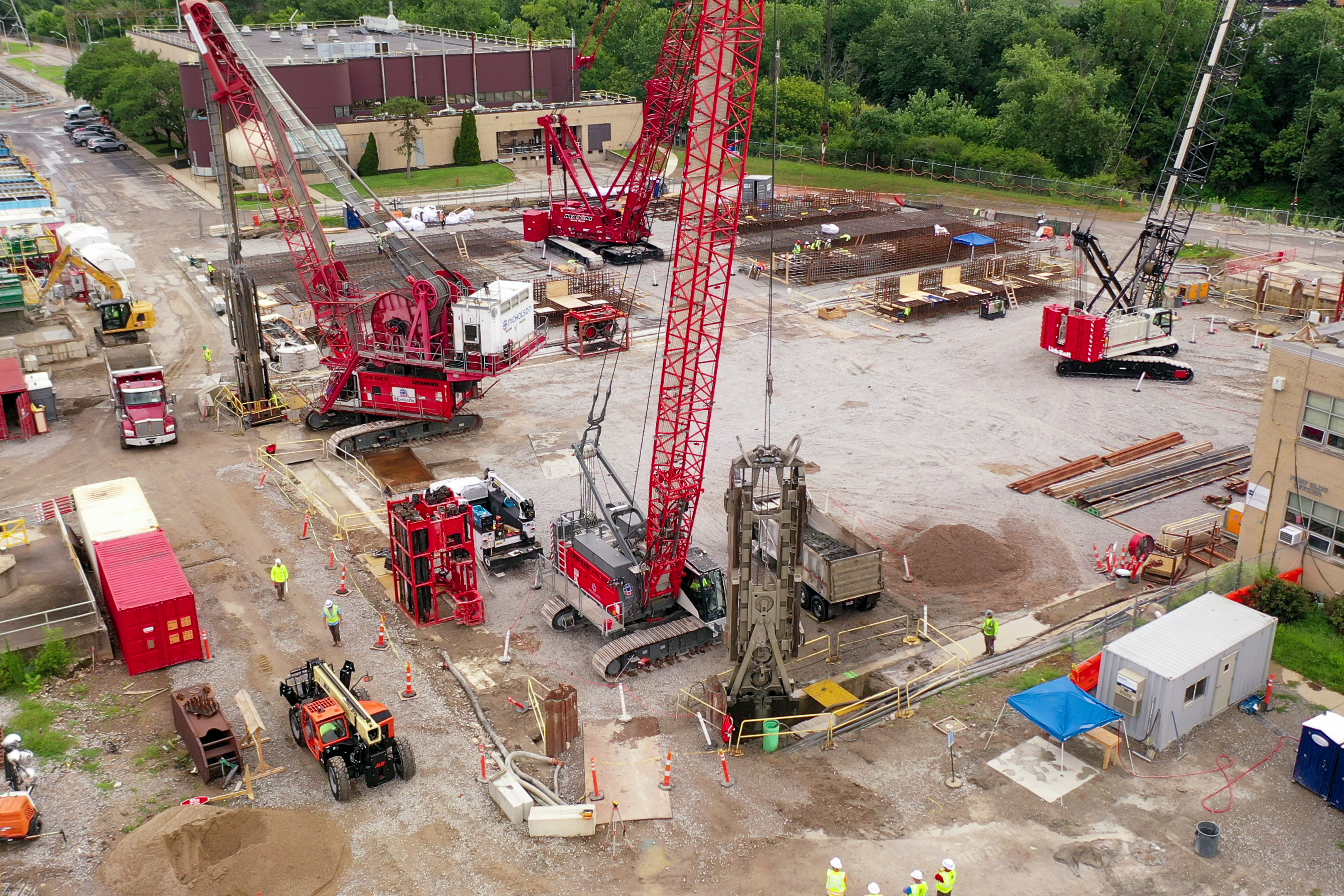

  • End of 2025 - 2032: Construct the new pump station and associated facilities.
  • Spring 2025 - Spring 2026: Construct a new main entrance gate along Gest Street (adjacent to the Grit Building) and reconfigure the Evans Street gate to handle truck traffic.
  • Early 2025 through December 2025 (COMPLETED): Construct third floor on CMF Building, drill geothermal wells in the Admin/CMF parking lot to heat/cool the building, and demo the old Administration Building and old Administration Building Annex.
